Steel Frame Construction: The Complete Canadian Buyer’s Guide

Steel frame construction is a building method in which a skeleton of steel columns, beams, and rafters carries all structural loads, allowing large clear-span interiors without load-bearing walls. It is the dominant approach for commercial, industrial, agricultural, and aviation buildings across Canada because steel delivers high strength-to-weight ratios, predictable engineering performance, and long service life under Canadian snow, wind, and seismic conditions. This guide explains every major system type, how to compare them, and what drives cost and timeline on a real project.

Key takeaways

  • Steel frame construction separates the structural skeleton from the cladding, giving owners maximum flexibility in layout and future expansion.
  • Pre-engineered metal buildings (PEMBs) and conventional structural steel are the two main branches, each suited to different span, load, and customization requirements.
  • Canadian projects must comply with the National Building Code of Canada (NBC) and provincial amendments; engineering drawings stamped by a licensed professional engineer are required for permits.
  • Cost is driven primarily by steel tonnage, frame complexity, span width, snow and wind load zone, and site conditions, not by a fixed price per square foot.
  • Lead times for fabricated steel packages range from several weeks for standard PEMBs to several months for complex conventional frames; early engagement with a supplier compresses the schedule.

Definitions & scope

Steel frame construction refers to any building system in which the primary structural load path runs through a framework of steel members rather than through masonry, wood, or concrete walls. The frame resists gravity loads (dead load, live load, snow) and lateral loads (wind, seismic) and transfers them to the foundation.

Within this broad category, two principal systems are relevant to Canadian buyers of pre-engineered and structural steel buildings:

  • Pre-engineered metal buildings (PEMBs): factory-designed rigid frames manufactured to a specific project brief, shipped as a kit, and erected on site. The engineering is embedded in the manufacturing process.
  • Conventional structural steel: custom-fabricated wide-flange sections, hollow structural sections (HSS), and plate girders designed by a project engineer of record for complex geometries, heavy loads, or multi-storey applications.

Secondary framing members, including purlins, girts, and eave struts, attach to the primary frame and support roof and wall cladding panels. The cladding itself, typically insulated metal panels or standing-seam roofing, is not structural but contributes to the building envelope’s thermal and weather performance. This guide covers single-storey and low-rise applications most common in agricultural, commercial, industrial, and aviation contexts across Canada.

Why this matters

Canada’s climate imposes structural demands that make the choice of frame system consequential. Ground snow loads range from under 1.0 kPa in parts of coastal British Columbia to over 4.0 kPa in northern Ontario, Quebec, and Atlantic Canada, according to the NBC climatic data tables. Wind pressures vary significantly between prairie open exposures and sheltered urban sites. Seismic hazard is material in British Columbia and parts of Quebec and the Ottawa Valley. A frame system that is correctly engineered for these site-specific loads will perform reliably for decades; one that is under-specified or improperly erected creates liability and safety risk.

Beyond structural performance, the frame system determines interior usability. Clear-span rigid frames eliminate interior columns, which is critical for aircraft hangars, riding arenas, manufacturing floors, and large agricultural storage. Multi-span frames with interior columns can cover very large footprints economically but constrain equipment movement and future reconfiguration.

The frame system also affects construction speed. A PEMB package arrives with pre-punched holes, pre-welded base plates, and numbered components, allowing a trained crew to erect the primary frame in days rather than weeks. Conventional steel requires more field fitting and is typically slower per square metre but handles irregular geometries and heavy crane loads that exceed PEMB design envelopes.

Understanding these trade-offs before engaging a supplier prevents costly redesigns and helps owners match the system to the actual operational life of the building. For a deeper look at how pre-engineered and conventional systems compare on cost and timeline, see the guide on PEMB vs. conventional steel cost, timeline and ROI in Canada.

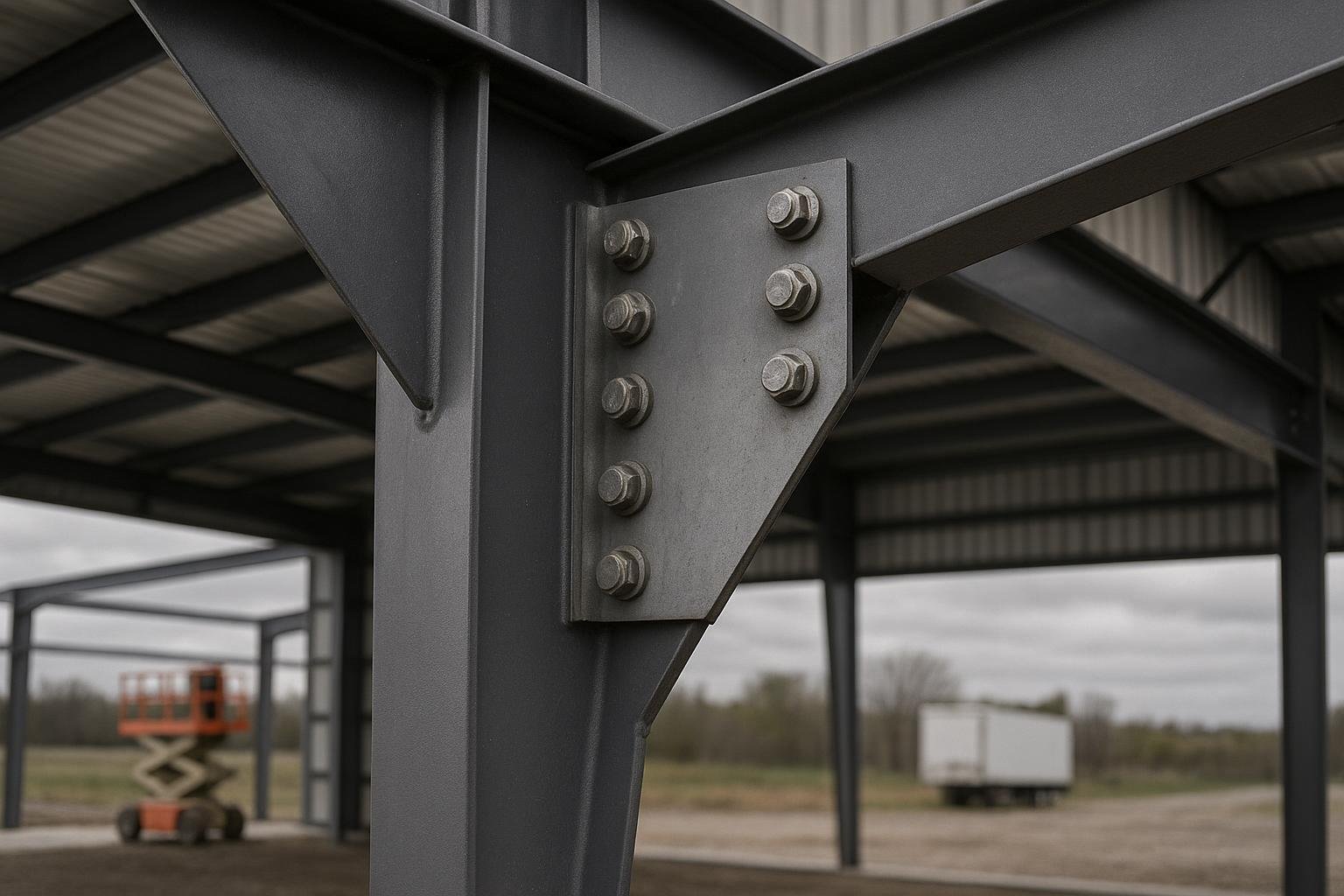

Bolted knee connection between steel column and rafter on a rigid frame

Your options

Clear-span rigid frame (PEMB)

What it is: A tapered or straight rigid frame fabricated from welded plate steel, designed by the manufacturer’s engineering team to the project’s specific span, eave height, loads, and bay spacing. Frames are bolted together on site.

How it works: Moment-resisting connections at the knee (column-to-rafter junction) and ridge allow the frame to act as a single structural unit, distributing loads without interior columns. Secondary purlins and girts span between primary frames, typically at 1.5 m to 2.0 m spacing.

Best for: Agricultural buildings, garages, workshops, warehouses, and aircraft hangars requiring unobstructed interior space. Economical for widths up to approximately 90 m depending on load zone.

Limitations: Very wide clear spans increase steel tonnage rapidly. Highly customized architectural profiles may require supplementary engineering beyond the manufacturer’s standard design envelope.

Multi-span rigid frame (PEMB)

What it is: Two or more clear-span bays joined at interior columns, allowing very large footprints while keeping individual frame spans within an economical range.

How it works: Interior columns carry gravity loads at the valley points. Frames on either side of each interior column are designed as separate rigid frames sharing the column.

Best for: Large warehouses, distribution centres, and manufacturing plants where total footprint matters more than column-free space. See the guide on steel warehouse construction in Canada for application detail.

Limitations: Interior columns restrict forklift travel paths and future reconfiguration. Valley gutters between bays require careful detailing to prevent ice damming in cold climates.

Modular or lean-to frame

What it is: A single-slope frame that attaches to an existing building or stands independently, sharing one wall with a primary structure.

How it works: The high side of the lean-to connects to the existing building’s structural frame or a dedicated endwall column. The low side carries its own column and foundation.

Best for: Additions to existing steel buildings, covered equipment bays, and loading dock canopies where budget is limited and the primary structure can accept the added load.

Limitations: The existing building must be verified by an engineer to accept the new lateral and gravity loads. Drainage from the lean-to roof must be managed to avoid ice accumulation against the parent wall.

Conventional structural steel frame

What it is: A custom-fabricated frame using wide-flange (W-shape) sections, HSS columns, and plate girders designed by the project’s engineer of record and fabricated by a certified steel fabricator.

How it works: The engineer of record produces detailed drawings; a fabricator cuts, drills, and welds members to those drawings; an erector assembles the frame on site with bolted or welded connections.

Best for: Multi-storey buildings, heavy industrial facilities with overhead crane loads exceeding PEMB envelopes, complex geometries, and projects requiring specific architectural expression. See structural steel buildings for Titan’s offering in this category.

Limitations: Longer design and fabrication lead times. Higher engineering cost per project. Requires a certified fabricator under CSA W47.1 or equivalent. Generally more expensive per square metre than PEMB for standard rectangular buildings.

Light-gauge steel framing

What it is: Cold-formed steel studs, tracks, and joists used for interior partition walls, mezzanines, and infill panels within a primary steel frame building.

How it works: Cold-formed sections are roll-formed from thin sheet steel (typically 0.84 mm to 2.46 mm) and connected with self-drilling screws or welding. They carry light loads and are not primary structural members in large-span buildings.

Best for: Office interiors, mezzanine floors, and demising walls inside a primary steel frame building. Also used as the primary framing system for low-rise residential and small commercial buildings outside the scope of this guide.

Limitations: Not suitable as primary framing for large-span agricultural, industrial, or aviation buildings. Requires thermal bridging mitigation in cold-climate wall assemblies.

Hybrid steel-concrete frame

What it is: A system combining a steel superstructure with a concrete podium, core walls, or composite floor slabs, common in multi-storey commercial and institutional buildings.

How it works: Steel columns and beams support composite metal deck floor slabs with a concrete topping. Concrete shear walls or braced steel frames resist lateral loads.

Best for: Multi-storey office, retail, or mixed-use buildings where floor-to-floor height efficiency and fire resistance ratings are priorities.

Limitations: Complexity of two trades (structural steel and concrete) on the critical path increases coordination risk. Outside the typical scope of pre-engineered building suppliers; requires a general contractor and full project engineering team.

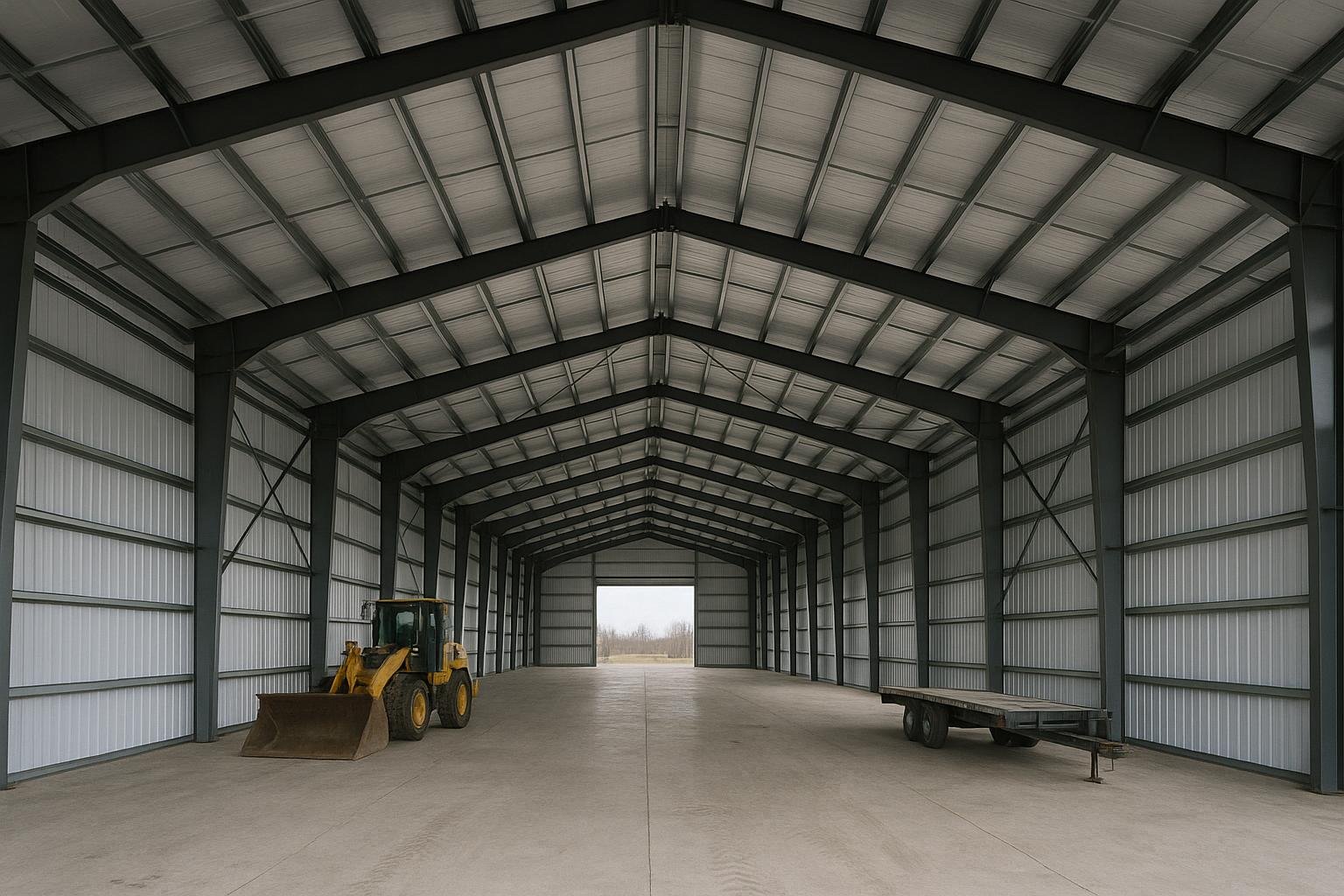

Multi-span steel frame warehouse interior with columns and valley gutter framing

Options compared

Steel Frame Construction Systems: Comparison Overview
SystemBest forTypical considerationsDurability / limitations
Clear-span rigid frame (PEMB)Hangars, arenas, ag storage, garages up to ~90 m wideFactory-engineered; fast erection; bolted connections50+ year design life; limited to manufacturer’s standard load envelopes
Multi-span rigid frame (PEMB)Large warehouses, distribution centres, manufacturing plantsInterior columns reduce steel tonnage; valley gutter detailing critical50+ year design life; interior columns constrain future layout changes
Modular / lean-to frameAdditions, covered bays, dock canopiesAttaches to existing structure; low cost for added covered areaDependent on host structure integrity; drainage detailing required
Conventional structural steelHeavy industrial, multi-storey, complex geometryCustom engineering; CSA-certified fabricator required; longer lead timeIndefinite design life with maintenance; highest design flexibility
Light-gauge steel framingInterior partitions, mezzanines, small commercialNot a primary frame for large spans; fast installation for secondary workDurable for intended loads; thermal bridging must be managed
Hybrid steel-concreteMulti-storey commercial, institutionalTwo-trade coordination; composite floor efficiencyLong service life; highest complexity and cost

For most agricultural, commercial, and industrial buyers in Canada, the clear-span or multi-span PEMB rigid frame delivers the best balance of cost, speed, and structural performance. Conventional structural steel becomes the right answer when loads, geometry, or regulatory requirements exceed what a PEMB manufacturer’s standard design envelope can accommodate. Light-gauge and hybrid systems serve secondary or multi-storey roles that fall outside the core pre-engineered building market. The decision framework below helps narrow the choice to your specific project.

How to choose

Use the following decision criteria to identify the right steel frame construction system before requesting a quote.

Choose a clear-span PEMB if your building is a single-storey rectangular or near-rectangular structure up to approximately 90 m wide, you need an unobstructed interior for aircraft, livestock, vehicles, or equipment, and your schedule favours a fast-track approach with a factory-engineered package. This covers the majority of agricultural buildings, garages, workshops, warehouses, and hangars. See pre-engineered steel buildings for Titan’s PEMB product line.

Choose a multi-span PEMB if your footprint exceeds what a single clear-span frame can cover economically, and interior columns at regular intervals are acceptable for your operations. This is the standard choice for large distribution and manufacturing facilities.

Choose conventional structural steel if your project involves heavy overhead cranes (typically above 10 to 15 tonnes capacity), multi-storey construction, irregular plan geometry, or architectural requirements that cannot be met within a manufacturer’s standard catalogue. Verify that your fabricator holds CSA W47.1 certification for welded steel structures.

Choose a lean-to or modular addition if you are expanding an existing steel building and the host structure has been verified by an engineer to accept the added loads. This is the most cost-effective way to add covered area to an existing facility.

Consider your snow and wind load zone early. Buildings in high-load zones such as northern Ontario, Quebec, and Atlantic Canada require heavier frame sections. Confirming the site’s design loads before selecting a system prevents under-specification. The guide on steel building snow load in Canada explains how NBC climatic data applies to frame design.

Costs & timelines

No verified current price data for steel frame construction packages has been supplied to this guide. The following cost drivers are ranked by their typical influence on total project cost; consult a supplier for project-specific pricing.

Steel Frame Construction: Key Cost Drivers (Ranked)
RankCost driverWhy it matters
1Steel tonnage (span width, eave height, bay spacing)More steel means higher material and fabrication cost; wider clear spans increase tonnage rapidly
2Design snow and wind loadsHigh-load zones require heavier sections; northern and Atlantic sites carry a structural premium
3Frame complexity (cranes, mezzanines, irregular geometry)Each added feature requires additional engineering and fabrication labour
4Foundation type and site conditionsPoor bearing soils, high frost depth, or rock require more expensive foundations; see steel building foundation requirements
5Erection labour and site accessRemote sites, difficult access, or winter erection increase labour cost; see steel building erection cost in Canada
6Cladding and insulation specificationInsulated metal panels, standing-seam roofing, and high R-value insulation add cost but reduce operating energy expense
7Steel market pricing and tariff environmentGlobal steel prices and Canadian trade policy affect fabricated steel costs; see steel building costs and tariff-free procurement

Lead times for a standard PEMB package typically run from several weeks to a few months from order to delivery, depending on the manufacturer’s production schedule and project complexity. Conventional structural steel fabrication generally requires a longer lead time. Site preparation, foundation work, and permit approval run concurrently with fabrication when the project is well-coordinated, compressing the overall schedule. For a broader cost overview, see the 2026 Canadian steel building buyer’s guide.

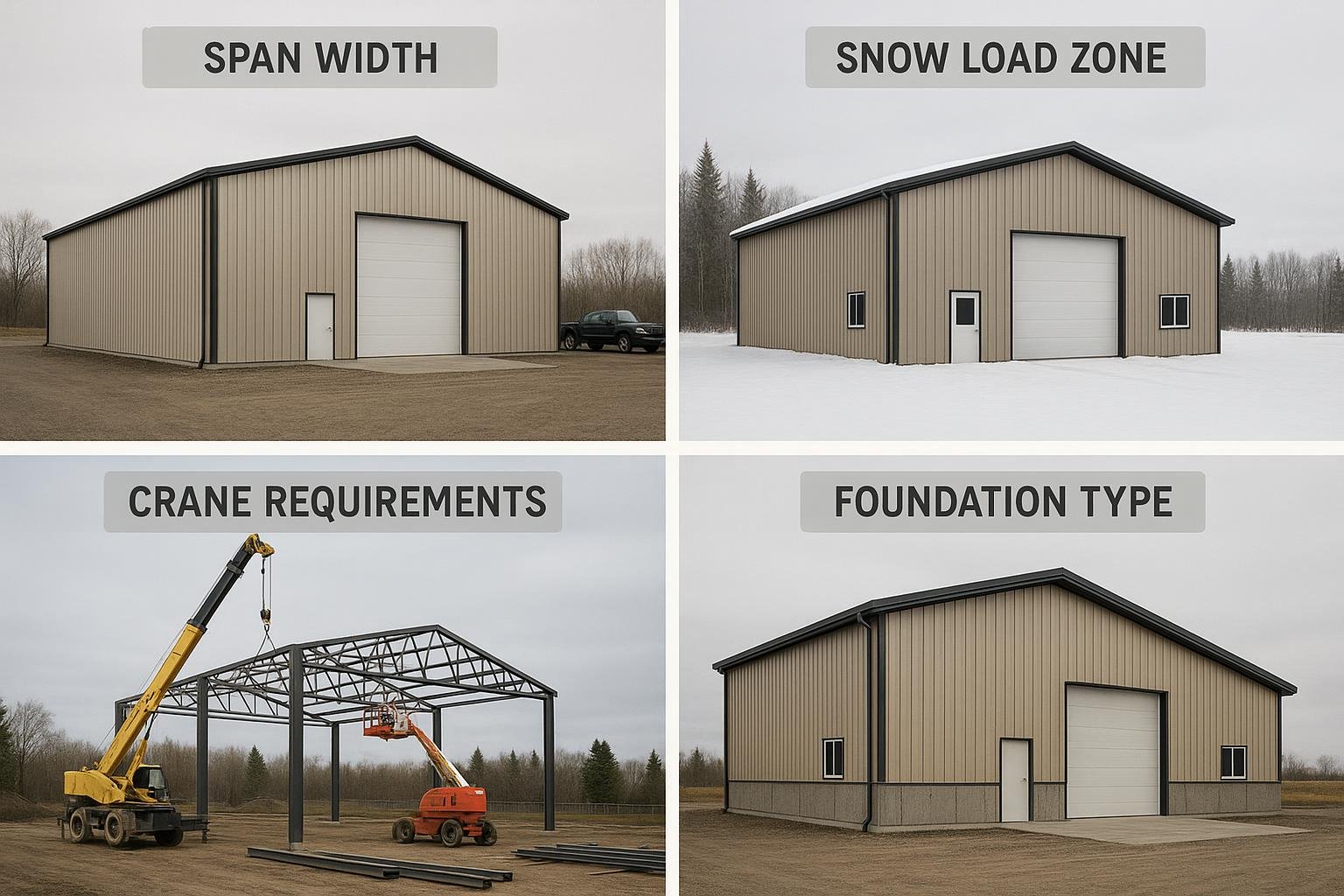

Illustration of key cost drivers for steel frame construction projects in Canada

Risks & common mistakes

Under-specifying design loads. Using a neighbouring province’s snow or wind data instead of the site-specific NBC climatic values is a common error that results in a frame that does not meet the building code. Always confirm the design loads with the authority having jurisdiction (AHJ) before finalizing the frame design.

Skipping the geotechnical investigation. A steel frame transfers concentrated column loads to the foundation. Without a soils report, the foundation may be under-designed for actual bearing capacity, leading to settlement and frame distortion. This is especially relevant on sites with fill, organic soils, or high water tables.

Ordering without stamped engineering drawings. Canadian building permits require drawings stamped by a licensed professional engineer registered in the province of construction. Purchasing a steel kit without this documentation delays the permit and may require costly redesign. See steel building permits in Canada for the full compliance picture.

Ignoring future expansion in the initial design. Adding a lean-to or extending the building length is straightforward if the endwall frames and anchor bolts are designed for it from the start. Retrofitting expansion capability after the fact is significantly more expensive.

Mismatching the frame system to the crane requirement. PEMB manufacturers offer crane packages, but very heavy or high-duty-cycle cranes may exceed the standard design envelope. Confirm crane capacity, runway beam span, and duty cycle with the frame manufacturer before ordering.

Neglecting cold-climate detailing. Valley gutters in multi-span buildings, eave overhangs, and roof slope all affect snow accumulation and ice damming. The guide on steel building options for cold climates covers design choices that reduce winter maintenance risk.

Selecting a supplier without verifying engineering credentials. A reputable steel building partner provides stamped engineering drawings, a clear scope of supply, and documented compliance with CSA A660 or equivalent standards. The guide on evaluating metal and steel building suppliers in Canada outlines the questions to ask.

How the process works

  1. Define the project brief. Establish the building’s intended use, required clear span, eave height, bay spacing, crane requirements, and site location. Confirm the site’s NBC climatic design data (snow, wind, seismic) with the local AHJ or a professional engineer.
  2. Engage a steel building partner and request a quote. Provide the project brief to one or more suppliers. A credible partner will ask detailed questions about loads, site conditions, and future expansion before quoting. See working with a steel building partner in Canada for guidance on this stage.
  3. Complete engineering and permit drawings. The manufacturer’s engineering team or the project’s engineer of record produces stamped drawings. These are submitted to the AHJ for building permit approval. Foundation design runs concurrently, informed by the geotechnical report.
  4. Fabricate and deliver the steel package. Once the permit is approved and the order is placed, the primary frame, secondary framing, cladding, and fasteners are fabricated and shipped to site. Components are labelled for erection sequence.
  5. Prepare the site and pour the foundation. Anchor bolts are set to the approved layout drawing before the concrete cures. Bolt placement accuracy is critical; errors require costly correction. See steel building anchor bolts for tolerance requirements.
  6. Erect the steel frame and install cladding. A certified erection crew sets primary frames, installs secondary framing, and applies roof and wall panels. Inspections occur at stages specified by the AHJ.
  7. Complete mechanical, electrical, and interior fit-out. After the building envelope is closed, mechanical, electrical, and insulation trades complete the interior to the occupancy specification. Final inspection and occupancy permit close the process.

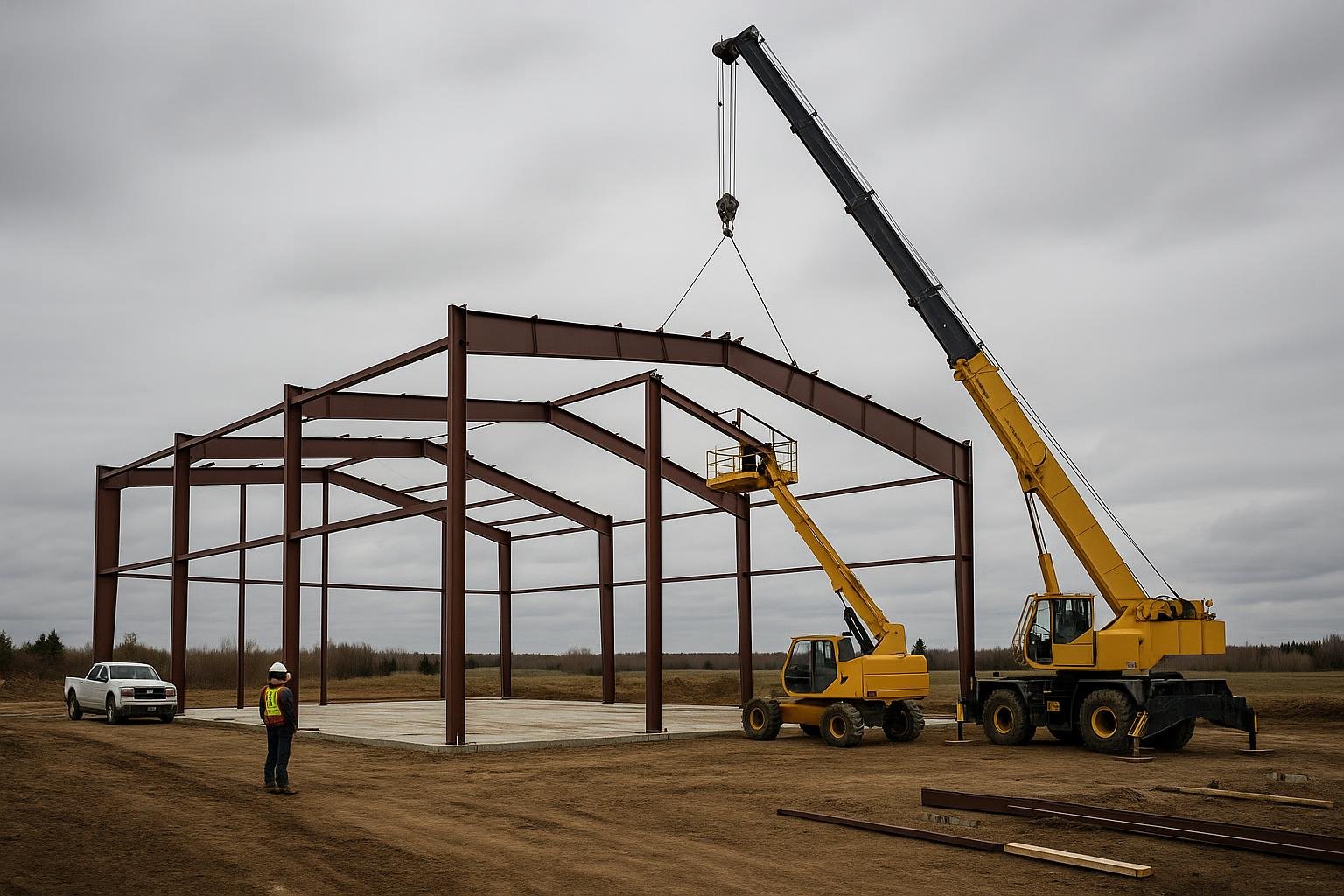

Crane lifting steel rigid frame section onto anchor bolts during building erection

Frequently asked questions

What is the difference between a steel frame building and a pre-engineered metal building?

A pre-engineered metal building (PEMB) is a specific type of steel frame construction in which the frame is designed and fabricated by the manufacturer as a complete system for a defined set of loads and dimensions. Conventional steel frame construction uses custom-fabricated members designed by a project engineer of record. All PEMBs are steel frame buildings, but not all steel frame buildings are PEMBs. The distinction matters for cost, lead time, and the complexity of loads the system can handle.

What spans are achievable with a clear-span steel rigid frame?

Pre-engineered rigid frames routinely achieve clear spans of 15 m to 90 m for standard agricultural, commercial, and industrial applications. Wider spans are possible with conventional structural steel or hybrid systems but require significantly more steel tonnage and custom engineering. The practical upper limit for a PEMB clear span depends on the design snow and wind loads at the specific site; high-load zones reduce the economical span range. Confirm the maximum span for your load zone with your supplier’s engineering team.

Does a steel frame building require a building permit in Canada?

Yes. All provinces and territories require a building permit for permanent steel frame structures. Permit applications must include stamped engineering drawings prepared by a professional engineer licensed in the province of construction. Agricultural buildings on farm properties may be subject to different requirements under provincial farm building codes, but this varies by province and municipality. Always confirm permit requirements with the local AHJ before ordering a steel package. The guide on steel building permits in Canada provides a province-by-province overview.

How long does a steel frame building last in Canada?

A properly engineered, erected, and maintained steel frame building is designed for a service life of 50 years or more. The primary frame members are protected by primer and paint coatings applied at the factory; cladding panels use Galvalume or painted steel with manufacturer-specified coating warranties. Maintenance requirements include periodic inspection of fasteners, sealants, and coatings, particularly in coastal or high-humidity environments. The guide on steel building lifespan in Canada covers maintenance factors in detail.

Can a steel frame building be expanded after it is built?

Yes, provided the original design anticipated expansion. Extending a building along its length (adding bays) is straightforward when the endwall frames are designed as expandable and the foundation layout accommodates new anchor bolts. Adding a lean-to along a sidewall is also common. Widening a building by adding a new clear-span frame adjacent to the existing one requires engineering review of the shared column and foundation loads. Discuss expansion intent with your supplier at the design stage to avoid costly retrofits.

What foundation type does a steel frame building need?

The appropriate foundation depends on soil bearing capacity, frost depth, building loads, and local code requirements. Common options include concrete perimeter walls with footings, isolated column piers, and full concrete slabs with thickened edges. The primary frame transfers concentrated column loads to the foundation through anchor bolts, so the foundation must be designed to match the frame’s base reaction forces. Geotechnical investigation is strongly recommended before foundation design. See steel building foundation requirements for a complete Canadian guide.

How does steel frame construction perform in high snow load zones?

Steel rigid frames are engineered to the site-specific ground snow load from the NBC climatic data tables, converted to a roof snow load using the building’s geometry and exposure. In high-load zones such as northern Ontario, Quebec, and Atlantic Canada, the frame sections are heavier and the roof slope may be increased to shed snow. The frame itself does not degrade under repeated snow loading when correctly designed. Roof slope, valley gutter detailing, and insulation continuity are the critical design variables in high-snow environments. See steel building snow load in Canada for load calculation guidance.

What is the typical erection time for a steel frame building?

Erection time depends on building size, frame complexity, crew size, and weather. A small to mid-size PEMB (for example, a single-bay agricultural building or garage) can have its primary frame erected in a few days by an experienced crew. A large warehouse or industrial building with multiple bays may require several weeks of erection work. Erection is only one phase; site preparation, foundation curing, cladding installation, and interior fit-out add to the total construction schedule. Early coordination between the erection crew and the steel package delivery date prevents costly delays.

Is steel frame construction suitable for agricultural buildings in Canada?

Steel frame construction is widely used for Canadian agricultural buildings including grain storage, equipment storage, livestock barns, and riding arenas. Clear-span rigid frames eliminate interior columns that would obstruct equipment movement and animal housing. Steel does not rot, is resistant to pests, and can be detailed to meet provincial agricultural building codes. The guide on engineered buildings for Canadian agriculture covers agricultural-specific design considerations including ventilation, drainage, and livestock welfare requirements.

If you are planning a steel frame construction project in Canada, Titan Steel Buildings can help you define the right system, confirm site-specific design loads, and move from concept to stamped engineering drawings. Request a quote or visit the metal buildings overview to explore the full range of building types and sizes available.
