Steel Building Foundation Requirements: A Complete Canadian Guide

Steel building foundation requirements govern how a pre-engineered steel structure transfers its loads safely into the ground. Meeting these requirements is non-negotiable: the foundation must resist dead loads, live loads, wind uplift, seismic forces, and frost heave specific to the Canadian site. Choosing the wrong foundation system or undersizing it can compromise the entire structure, void engineering stamps, and create costly remediation work after erection. This guide explains every major option, the factors that drive the decision, and the process for getting it right.

  • Foundation type is determined by soil bearing capacity, frost depth, building size, and local building code requirements, not by personal preference.
  • Anchor bolt placement is the critical interface between the steel frame and the foundation; errors here cannot be corrected cheaply after the fact.
  • A geotechnical report is strongly recommended for any building larger than a small accessory structure and is required by many municipalities.
  • Canadian frost depths range from roughly 400 mm in coastal British Columbia to over 2,400 mm in northern regions, directly controlling footing depth.
  • The foundation is typically the largest single site-work cost driver and must be budgeted before a steel kit quote is finalized.

Definitions and scope

A foundation is the structural system that sits below or at grade and transfers all building loads to competent soil or bedrock. For a pre-engineered metal building (PEMB), the foundation also anchors the rigid-frame columns through a precisely located pattern of anchor bolts cast into the concrete. The term “foundation requirements” covers three interrelated elements: the structural design of the footing or slab itself, the geotechnical conditions of the site, and the code and permit obligations imposed by the authority having jurisdiction (AHJ).

In Canada, foundation design falls under the National Building Code of Canada (NBC) and its provincial adoptions, as well as CSA A23.3 for concrete design and CSA S16 for the steel superstructure. The NBC classifies soil into bearing categories and sets minimum requirements for frost protection. Provincial and municipal amendments can add further requirements, particularly in seismic zones such as coastal British Columbia and parts of Quebec. Every engineered steel building supplied to a Canadian site must include a foundation drawing or reaction sheet that specifies column base plate dimensions, anchor bolt size, spacing, and embedment depth so that a local engineer of record can design a compliant foundation.

Why this matters

The foundation is the only part of a steel building project that cannot be factory-engineered in advance without site-specific data. The steel superstructure is designed to precise tolerances; if the anchor bolts are mislocated by even a few millimetres, base plates may not align, columns cannot be plumbed, and the entire frame geometry is thrown off. Correcting mislocated anchor bolts after concrete has cured typically requires core drilling, epoxy-set replacement bolts, and re-engineering, all of which add significant cost and delay.

Beyond geometry, an undersized foundation creates long-term structural risk. Pre-engineered steel buildings concentrate their loads at discrete column points rather than distributing them along a continuous wall, so the bearing pressure under each footing can be substantially higher than in a conventional wood-frame building of the same footprint. Soft or expansive soils, a high water table, or inadequate frost protection can cause differential settlement that racks the frame, distorts door openings, and damages cladding.

Canadian climate amplifies these risks. Frost heave, the volumetric expansion of saturated soil during freezing, exerts upward forces that can lift an improperly designed footing and the column attached to it. The NBC requires footings to bear below the local frost depth or to be designed as frost-protected shallow foundations (FPSF) with insulation. Getting this right from the start protects the building’s long-term lifespan and ensures the structure performs as engineered throughout Canada’s demanding seasonal cycles.

Permit authorities across Canada increasingly require a geotechnical investigation report before issuing a building permit for any commercial or industrial steel structure. Understanding foundation requirements early also allows accurate budgeting, since foundation costs can represent a significant share of total project cost depending on soil conditions and building size. For a detailed look at how site prep fits into overall project budgets, see the 2026 Canadian Steel Building Buyer’s Guide.

Your options

Continuous perimeter strip footing with slab-on-grade

What it is: A reinforced concrete strip footing runs around the building perimeter below frost depth. A separate interior slab-on-grade is poured on compacted granular fill. Anchor bolts for perimeter columns are cast into the strip footing or into thickened slab edges at column locations.

How it works: The strip footing distributes column point loads along its length and bears on undisturbed or engineered fill soil. The slab provides the floor surface and, when tied to the footing, adds lateral resistance.

Best for: Small to medium agricultural buildings, garages, workshops, and storage buildings on sites with adequate soil bearing capacity and uniform conditions.

Limitations: Requires careful compaction of interior fill before slab pour. Not suitable for very soft soils or sites with high differential settlement risk without additional engineering.

Isolated spread footings (pad footings)

What it is: Individual reinforced concrete pads are placed under each rigid-frame column. The pads are sized to spread the concentrated column load over enough soil area to stay within the allowable bearing pressure.

How it works: Each pad is excavated and poured independently. Anchor bolts are set in a template before the pour. A separate slab-on-grade is poured between columns after the footings cure.

Best for: Larger commercial and industrial buildings where interior columns are present, and where soil conditions are reasonably uniform across the site. Common for warehouses and manufacturing facilities.

Limitations: Differential settlement between pads is possible if soil conditions vary across the footprint. Requires accurate survey layout to ensure bolt patterns match the steel frame drawings exactly.

Continuous wall foundation (full basement or crawl space)

What it is: A full-height poured concrete or concrete masonry unit (CMU) wall extends from a footing below frost depth to grade or above, creating a basement or crawl space below the steel building.

How it works: The steel frame columns bear on top of the concrete wall via base plates and anchor bolts set at the top of the wall. The wall itself acts as a grade beam and retaining structure.

Best for: Buildings where below-grade space is needed for mechanical equipment, storage, or process areas. Also used when the site has a significant slope requiring a level floor elevation.

Limitations: Substantially higher cost than slab-on-grade options. Requires waterproofing and drainage design. Lateral soil pressure on the wall must be accounted for in the structural design.

Grade beam on piles or piers

What it is: Concrete piles or drilled piers extend below frost depth or through weak soil to competent bearing strata. A reinforced concrete grade beam spans between pile caps at grade level and carries the column anchor bolts.

How it works: Piles are driven or drilled first. Pile caps and the grade beam are then formed and poured. The steel frame erects on the grade beam just as it would on a conventional strip footing.

Best for: Sites with poor near-surface soils, organic material, fill, or high water tables where conventional spread footings cannot achieve adequate bearing. Also used in permafrost-adjacent or highly frost-susceptible zones.

Limitations: Highest cost foundation option. Requires a geotechnical report to specify pile type, diameter, and depth. Pile installation requires specialized equipment and subcontractors.

Frost-protected shallow foundation (FPSF)

What it is: A shallow footing placed above the normal frost depth, protected from freezing by a system of rigid insulation placed horizontally around the perimeter and under the slab. The NBC and CSA A920 provide design guidance for FPSF systems.

How it works: Insulation panels redirect the frost isotherm away from the footing, keeping the soil beneath it above freezing even in cold climates. Footing depth can be reduced significantly compared to a conventional frost-depth footing.

Best for: Heated buildings in regions where conventional frost depth would require very deep excavation. Can reduce excavation cost and concrete volume substantially.

Limitations: Not suitable for unheated buildings unless specifically designed for that condition. Requires careful detailing of insulation continuity. Less commonly accepted by all AHJs; verify local acceptance before specifying.

Helical pile foundation

What it is: Steel helical piles are screwed into the ground using hydraulic torque equipment. A steel bracket or concrete cap at the top of each pile receives the column base plate and anchor bolts.

How it works: Helical piles develop bearing through the helical plates bearing on soil at depth. Installation is fast, produces no spoil, and can be done in confined spaces or on slopes. Load capacity is verified by installation torque correlation.

Best for: Remote sites with limited access for concrete equipment, sites with environmental restrictions on excavation, or projects requiring very fast foundation installation.

Limitations: Capacity is sensitive to soil type and must be confirmed by a geotechnical engineer. Not suitable for very dense soils or sites with boulders. Long-term corrosion protection of the steel pile must be addressed in aggressive soil chemistries.

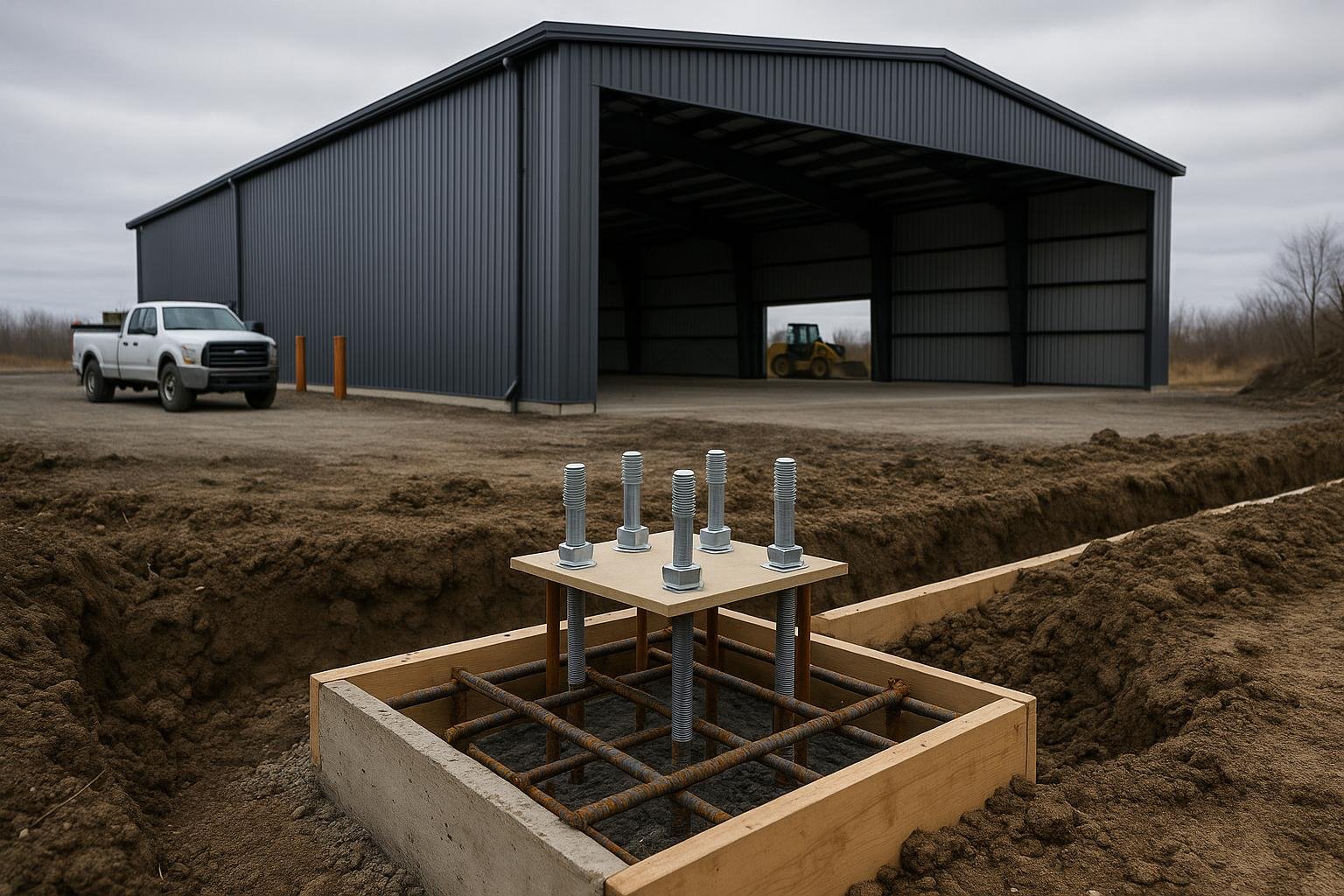

Reinforced concrete strip footing with anchor bolt template set in trench

Options compared

Foundation TypeBest ForTypical ConsiderationsKey Limitations
Perimeter strip footing + slabSmall to medium buildings on good soilModerate excavation, standard concrete workInterior fill compaction critical; not for soft soils
Isolated spread (pad) footingsLarger buildings, interior columnsIndividual excavations, precise bolt layoutDifferential settlement risk on variable soils
Full basement / crawl space wallBelow-grade space needed, sloped sitesHigh concrete volume, waterproofing requiredHighest cost among conventional options
Grade beam on piles/piersPoor near-surface soils, high water tableGeotechnical report required, specialized equipmentHighest overall cost, longer schedule
Frost-protected shallow foundationHeated buildings in deep-frost regionsInsulation detailing, AHJ acceptance neededNot for unheated buildings without special design
Helical pilesRemote sites, fast schedule, restricted accessTorque-verified capacity, steel corrosion protectionNot for dense soils or boulder-heavy ground

No single foundation type is universally superior. The strip footing with slab remains the most common choice for agricultural buildings, garages, and smaller commercial structures on sites with competent soil, because it is well understood by local concrete contractors and straightforward to inspect. Larger warehouses and industrial buildings on variable soils more often use isolated pad footings or grade beams. Helical piles have gained significant traction in Canada for their speed and minimal site disturbance, but they require a geotechnical engineer’s sign-off on capacity. The FPSF option can offer real cost savings in deep-frost regions for heated buildings, but requires early confirmation from the local AHJ. For a broader look at how foundation type interacts with overall building design, see the companion guide on steel building foundation types.

Large pre-engineered steel manufacturing plant building with clear-span roof

How to choose

The foundation decision is driven by engineering data, not aesthetics. Use the following framework to narrow your options before engaging a geotechnical or structural engineer.

Choose a perimeter strip footing with slab-on-grade if your site has a geotechnical report confirming adequate bearing capacity, the building is a single-storey agricultural, garage, or light commercial structure, and your local frost depth is manageable with conventional excavation depth.

Choose isolated spread footings if your building has interior rigid-frame columns, the footprint is large enough that a continuous perimeter footing would require excessive concrete volume, and soil conditions are reasonably uniform across the site.

Choose a grade beam on piles or piers if a geotechnical investigation reveals soft, organic, or fill soils near the surface, the water table is high, or the site is in a region with significant frost-susceptible soils that cannot be economically excavated to competent bearing.

Choose a frost-protected shallow foundation if the building will be continuously heated, the local AHJ accepts FPSF design, and the frost depth at your site is deep enough that conventional footing depth would add significant cost. Confirm insulation R-value requirements with your engineer.

Choose helical piles if the site has limited access for concrete trucks and excavation equipment, the project schedule is tight, or environmental regulations restrict soil disturbance. Always require torque-correlation records and a geotechnical engineer’s capacity confirmation.

Choose a full basement or crawl space wall if the building program requires below-grade space, the site has a significant grade change that must be accommodated, or mechanical and utility systems benefit from a protected below-grade environment.

Regardless of which type you select, the anchor bolt layout must be coordinated with the steel building manufacturer’s foundation reaction sheet before any concrete is poured. Titan’s engineering team provides this documentation as part of the building package. For context on how anchor bolts integrate with the steel frame, see the guide on steel building anchor bolts.

Costs and timelines

Foundation cost is driven by a hierarchy of factors. No verified current price data has been supplied to this guide, so the following describes cost drivers in ranked order rather than specific dollar figures. For project-level budgeting, consult a local concrete contractor and geotechnical engineer with your specific site data.

Cost DriverWhy It MattersRelative Impact
Soil conditions and bearing capacityPoor soils require deeper excavation, more concrete, or pilingVery high
Frost depthDeeper frost lines mean more excavation and concrete volumeHigh
Building footprint and column countMore columns mean more anchor bolt locations and footing padsHigh
Slab thickness and reinforcementHeavy equipment use or point loads require thicker, reinforced slabsModerate to high
Site access and topographyDifficult access increases equipment mobilization costModerate
Geotechnical investigationRequired for most commercial projects; adds upfront cost but reduces riskModerate (upfront)
Concrete pricing and local labourVaries significantly by province and seasonModerate

Timeline for foundation work ranges from a few days for a small helical pile installation to several weeks for a large poured concrete system that must cure before steel erection begins. Concrete typically requires a minimum curing period before anchor bolt loads are applied; your structural engineer will specify this. Factor foundation scheduling into the overall project timeline early, as delays in concrete work directly delay steel erection. For a broader view of erection costs and schedules, see the guide on steel building erection cost in Canada.

Risks and common mistakes

Skipping the geotechnical report. Assuming soil conditions based on neighbouring properties or visual inspection is one of the most common and costly mistakes on steel building projects. Soil conditions can vary dramatically within a single site. A geotechnical report is the only reliable basis for foundation design and is required by most permit authorities for commercial and industrial buildings.

Mislocated anchor bolts. Anchor bolts must be set to the exact dimensions shown on the manufacturer’s foundation reaction sheet. Even small errors in bolt spacing, projection height, or thread length can prevent column base plates from fitting correctly. Always use a rigid template during the pour and survey the bolt pattern before concrete sets. This is covered in detail in the anchor bolt guide.

Inadequate frost protection. Placing footings above the local frost depth to save excavation cost is a false economy. Frost heave can lift columns, rack frames, and damage cladding. The National Building Code of Canada specifies minimum frost depth requirements by region; provincial amendments may add further requirements. Verify the local frost depth with your AHJ before finalizing footing depth.

Insufficient slab thickness for intended use. A standard 100 mm slab is not adequate for forklifts, heavy vehicles, or concentrated point loads from racking systems. Agricultural buildings storing heavy equipment, warehouses with racking, and manufacturing facilities all require engineered slab designs with appropriate thickness and reinforcement. Specify the intended use loads to your engineer before the slab is designed.

Poor granular base preparation. The slab-on-grade performance depends heavily on the compaction and depth of the granular base beneath it. Inadequate compaction leads to slab cracking and settlement. Specify compaction testing and verify that the granular material meets the specified gradation before pouring.

Ignoring drainage. Water accumulation around footings increases hydrostatic pressure and frost-susceptibility. Ensure the site is graded to drain away from the building and that perimeter drainage is included in the design, particularly in regions with high annual precipitation or spring snowmelt events.

Failing to coordinate with the steel supplier early. Foundation design must be based on the manufacturer’s column reaction loads and anchor bolt layout. Starting foundation design before receiving the manufacturer’s engineering package risks having to modify or repour concrete. Coordinate with your steel building partner before any ground is broken. See the guide on steel building code compliance in Canada for more on sequencing.

Diagram comparing steel building categories for Quebec City buyers

How the process works

  1. Site assessment and geotechnical investigation. Engage a geotechnical engineer to conduct soil borings or test pits and produce a report with bearing capacity, frost depth, groundwater level, and foundation recommendations specific to your site and building loads.
  2. Obtain manufacturer’s foundation reaction sheet. Once the steel building design is confirmed, the manufacturer provides a foundation drawing showing column locations, base plate dimensions, anchor bolt size, spacing, projection, and embedment depth, along with column reaction loads (vertical, horizontal, and uplift) for each load combination.
  3. Foundation engineering and permit drawings. A local structural engineer of record uses the geotechnical report and the manufacturer’s reaction sheet to design the foundation system and produce stamped drawings for permit submission. This step is required by virtually all Canadian building permit authorities.
  4. Excavation and formwork. The site is excavated to the required footing depth. Forms are set for footings and grade beams. Anchor bolt templates are positioned and secured precisely to the layout dimensions on the foundation drawing.
  5. Concrete placement and curing. Concrete is placed, consolidated, and finished. Anchor bolt positions are verified by survey before the concrete sets. The foundation is allowed to cure to the specified strength before steel erection loads are applied.
  6. Inspection and approval. The local building inspector reviews the foundation before it is backfilled and before steel erection begins. Some jurisdictions require a concrete test cylinder program to verify specified compressive strength.
  7. Steel erection. Once the foundation is approved and anchor bolts are confirmed to be within tolerance, the steel frame erection can begin. Any bolt discrepancies identified at this stage must be resolved before columns are set.

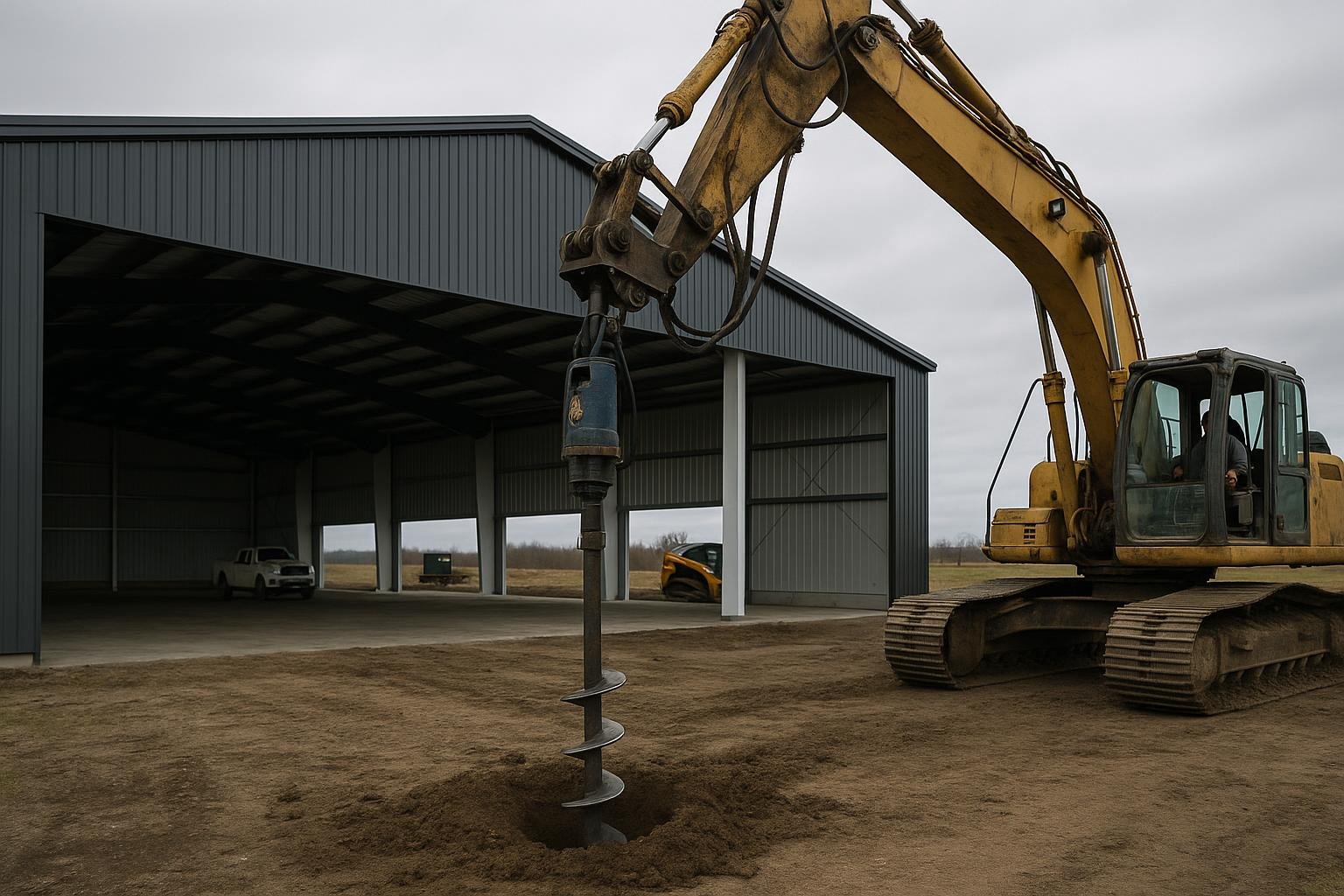

Helical pile installation with hydraulic torque drive at Canadian building site

Frequently asked questions

What is the minimum concrete strength required for a steel building foundation in Canada?

The NBC and CSA A23.3 set minimum concrete compressive strength requirements based on exposure conditions. For foundations exposed to freezing and thawing in a moist condition, a minimum specified compressive strength of 30 MPa is commonly required, with air entrainment. Your structural engineer will specify the appropriate strength class for your site’s exposure category. Always confirm with your local AHJ, as provincial amendments may impose higher minimums.

How deep do footings need to be in Canada?

Footing depth must reach below the local frost depth to prevent heave. Frost depths across Canada range from approximately 400 mm in mild coastal areas of British Columbia to over 2,400 mm in northern regions. The NBC provides a frost depth map, and local AHJs maintain records of the design frost depth for their jurisdiction. Your geotechnical engineer will confirm the required depth for your specific site and soil conditions.

Do I need a geotechnical report for a small agricultural building?

Requirements vary by province and municipality. Many rural AHJs do not mandate a geotechnical report for small agricultural structures, but it is still strongly advisable. Soil conditions that appear adequate visually can have hidden weak layers, organic material, or high water tables that lead to settlement or heave. The cost of a basic geotechnical investigation is small relative to the cost of foundation remediation after the building is erected.

Can I use an existing concrete slab as the foundation for a new steel building?

Possibly, but only after engineering evaluation. The existing slab must be assessed for thickness, reinforcement, concrete strength, condition, and whether it was designed to carry the column point loads of the new building. Anchor bolts must be installed using epoxy-set or mechanical anchor systems, which require engineering design and testing to confirm capacity. Do not assume an existing slab is adequate without a structural engineer’s review.

Who is responsible for designing the foundation: the steel building supplier or the buyer?

In Canada, the foundation is the buyer’s responsibility. The steel building manufacturer provides the column reaction loads and anchor bolt layout as part of the building package, but the foundation design must be performed by a licensed structural engineer of record retained by the buyer. This engineer is responsible for the foundation drawings submitted for permit. The manufacturer’s engineering covers the superstructure only. Confirm this division of responsibility in writing before signing any supply contract.

What happens if anchor bolts are in the wrong position after the concrete is poured?

Mislocated anchor bolts are a serious problem that must be resolved before steel erection. Options include core drilling and epoxy-setting new bolts, using oversized base plate holes with appropriate engineering approval, or in severe cases, breaking out and repouring the affected section. All remediation options require engineering sign-off. Prevention through accurate templating, survey verification before the pour, and a final check after stripping forms is far less costly than any remediation approach.

How does seismic zone affect foundation requirements?

In higher seismic zones, such as coastal British Columbia and parts of Quebec and the Ottawa Valley, foundations must be designed to resist lateral seismic forces in addition to gravity and wind loads. This can require larger footings, more reinforcement, hold-down anchor bolts with greater embedment, and in some cases grade beams connecting isolated footings to prevent differential movement. The NBC’s seismic design provisions apply to the foundation as well as the superstructure, and your structural engineer must address both.

Can a steel building be built on a gravel pad without concrete?

Some very small, temporary, or agricultural accessory structures use compacted gravel pads with surface-mounted helical pile brackets or timber sill plates, but this approach is not suitable for engineered pre-engineered metal buildings intended for permanent occupancy. Permanent PEMB structures require a concrete foundation with properly embedded anchor bolts to transfer column loads and resist uplift. Any deviation from a concrete foundation must be specifically engineered and approved by the AHJ.

How does the foundation affect the overall steel building project timeline?

Foundation work is typically on the critical path. Concrete must be placed, cured to specified strength, inspected, and approved before steel erection can begin. In Canadian winters, cold-weather concrete placement requires heated enclosures, insulated blankets, or scheduling adjustments, all of which add time and cost. Planning the foundation phase early and coordinating the concrete contractor’s schedule with the steel delivery date is essential to avoid costly delays on site.

If you are planning a steel building project and want to understand how foundation requirements interact with your building design, structural loads, and permit process, the Titan Steel Buildings team is available to provide the manufacturer’s engineering package and connect you with qualified local engineers. Visit our contact page to start the conversation, or explore the full range of metal buildings Titan supplies across Canada. You may also find the guides on steel framing for Canadian buildings and steel building permits and CSA-A660 compliance useful as you plan your project.
